BY SAMIE WAIKORI
The Ministry of Infrastructure Development (MID) has announced a series of relief works across several road networks in Honiara.
These efforts aim to maintain road conditions and address ongoing congestion issues within the city.
The relief work is also a response to infrastructure damage caused by the current adverse weather, affecting both Honiara and surrounding areas.
Speaking at a press conference on Tuesday, Deputy Secretary Technical of MID, Mike Qaqara, outlined the ongoing and upcoming relief projects.
He confirmed that the ministry is actively addressing the situation at Kohi Bridge, where a team has already been mobilised.
The team is working with procurement staff to secure a contractor for immediate repairs.
For the Honiara road network, Qaqara highlighted relief efforts along Hibiscus Avenue, specifically from the Town Ground roundabout to the Point Cruz Hot Bread Kitchen.
He mentioned that the permanent repairs for this stretch of road will be funded by DFAT under the National Transport Fund (NTF) and that the ministry is currently finalizing tenders for this project.
Qaqara explained that the current relief work on Hibiscus Avenue is designed to improve traffic flow in the short term, as MID is also managing other ongoing projects through the Land and Maritime Cooperation Project (LMCP), including work along the main road.
Additionally, the ministry is mobilizing local contractors to carry out grading work on the road segment from the Honiara City Council to Point Cruz Hot Bread Kitchen. This effort aims to ensure the road remains passable and help prevent congestion.
He emphasized that the relief work will continue until the LMCP project that now reaches Commonwealth Street to HCC roundabout is completed.
The Deputy Secretary also noted that the ministry is working on securing a contractor for relief work on the Mbokonavera Road and is prioritizing the Vura Road network.
Relief work on the Vura Road is already underway, and permanent repairs will be carried out by CAUSE, starting from the Vura roundabout to the Naha Birthing Centre and extending to the Police Station.
Qaqara further outlined plans for improvements on several feeder roads in Honiara, both sealed and unsealed.
The roads have been categorized into three zones; West, Central, and East Honiara, to help streamline monitoring and management of road works. Each zone has different traffic loads, and the ministry is focusing on specific roads within these areas.
In West Honiara, there are four unsealed and two sealed roads. The same applies to East and Central Honiara.
While some contracts for 2025 are in place for these roads, Qaqara mentioned that the allocated quantities for most roads have already been used up.
Still in Honiara, he also pointed out that the Lekapoli Road, which stretches from ITA to Chief’s House and down to the HCC, is being funded by DFAT through the National Transport Fund.

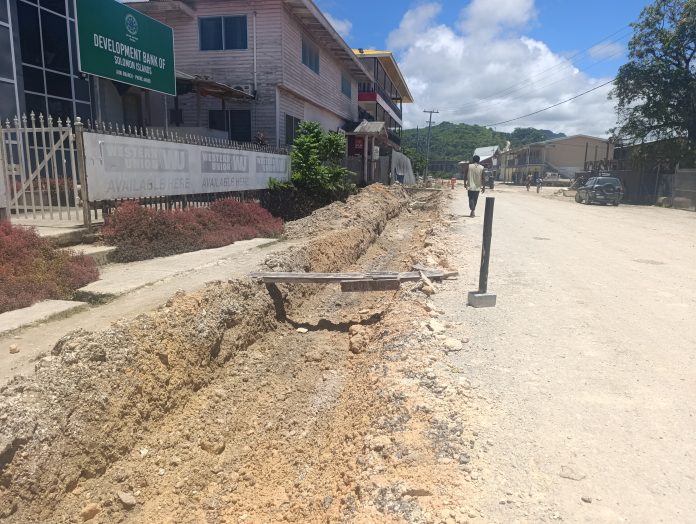

Additionally, ongoing projects include the Chinatown drainage, where a contractor is actively working, and the Kolale junction, which is part of the same contract. Another project, the Tasahe feeder road, is nearing the awarding stage.
These projects are part of the Ministry of Infrastructure Development’s efforts to improve Honiara’s road network and provide relief for commuters.
Photo: Supplied
